Description
The Metropolis of Tehran has long been faced with different traffic problems. One of Tehran’s traffic knots can be found in Municipal District 8, along the east-west axis of Janbazan Street just after Imam Ali Expressway. This traffic knot led to a heavy traffic congestion in the point where Imam Ali Expressway exits into Janbazan Street. This traffic congestion was also transferred to the North-South axis of Imam Ali Expressway. Previously, vehicles that passed along this axis and headed towards Janbazan Street and Nabovat Square used the U-turn located on the East-West axis of Janbazan Street and obstructed the traffic. Thus, Imam Ali Expressway – Janbazan Street Interchange was constructed to overcome this traffic problem.

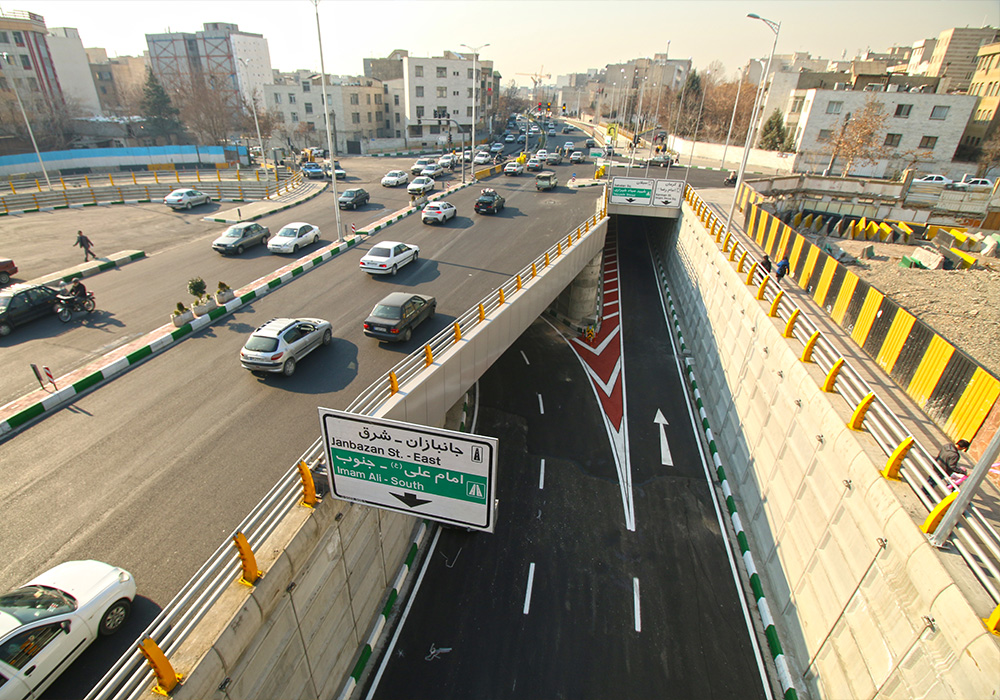

The project includes an east-west underpass along Janbazan Street. The first lane passes under Kerman Street and continues west. The second lane acts like a U-turn exit continuing toward Eastern Janbazan Street and Southern Imam Ali Expressway. Two underpass crossings make it possible for the vehicles to access Western Janbazan and Northern Kerman Streets through the East-West Axis of Janbazan Street. The projects total area is about 21,000 m2.
Scope of Work
- Traffic diversion operations, including roadbed preparation, and supplying and installing road direction signs, traffic posts, and Jersey concrete barriers (lane separation)
- Demolition and ownership conflict resolution (offices and machinery industrial sheds owned by Tehran Civil Engineering Organization)
- Excavation and roadbed preparation
- Pile drilling and driving (rebar binding, casing, concreting)

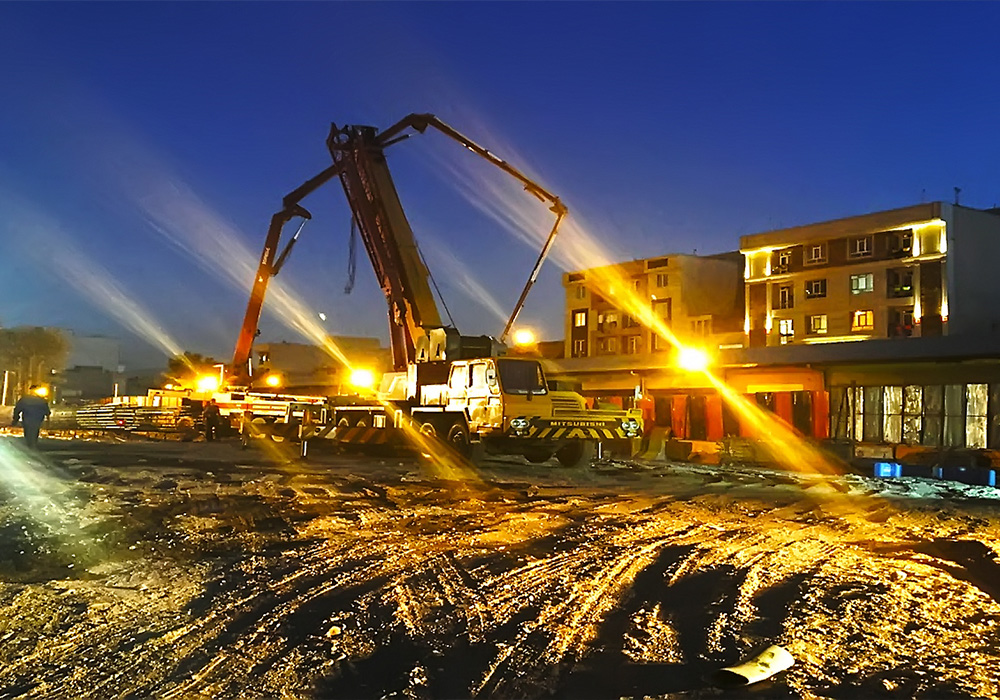

- Building the decks for Kerman structure and U-turn structure (foundation digging, rebar binding, formwork, and concreting operations)
- Handrail construction and installation
- Installing prefabricated concrete baseboards and facing panels on both axes (pile concrete finishing, roadbed preparation, and concreting behind the prefabricated concrete parts)
- Establishing handrail and pavement chainage (foundation digging, rebar binding, and formwork)
- Pavement flooring and installing prefabricated concrete curbs
- Composite gratings over street gutters
- Conflict resolution, 800-mm wastewater pipeline diversion (Kerman Street)
- Surface water collection and drainage
Key Statistics
- Excavation operations, 30,000 m3
- Pile drilling operations, 5,500 m
- Formwork operations, 3.100 m2
- Rebar binding operations, 1,500 tonnes
- Concreting operations, 13,000 m3
- Installing prefabricated concrete facing panels, 3,200 m2
- Curbing operations, 3,500 m
- Concrete curbing operations, 3,300 m
- Cobblestone pavement construction, 2,000 m2
- Handrail construction, 70,000 kg
- Baseboard construction, 1,700 m
